Shamrock Log Home Construction Day 34 - 49
Day 34
October 11th, Monday

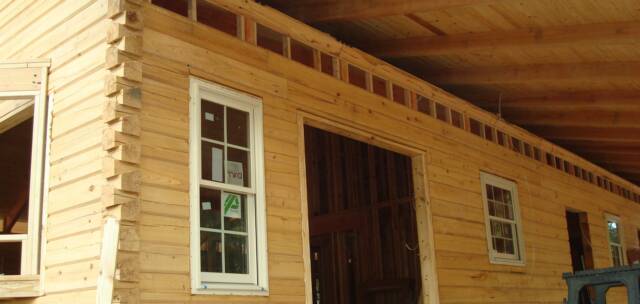

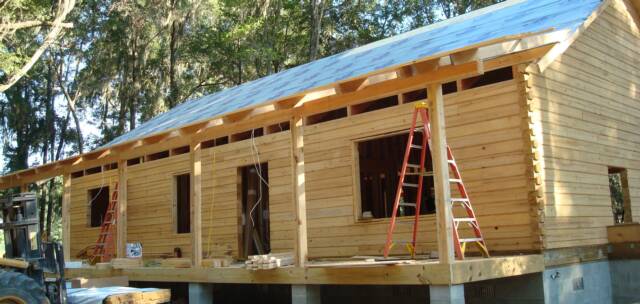

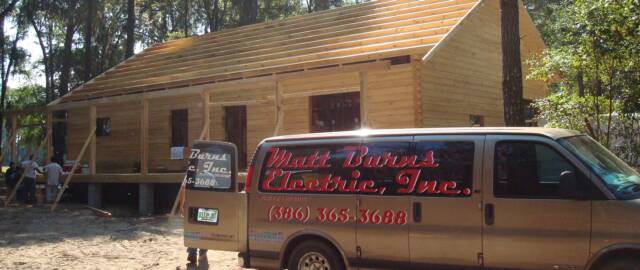

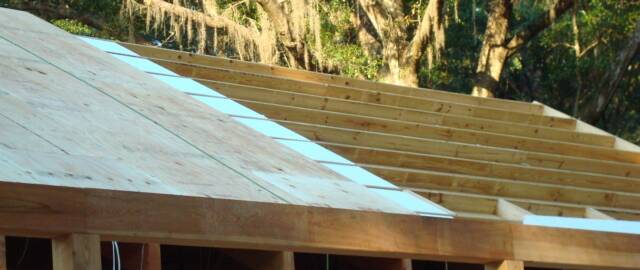

Day 34 – Electricians onsite met with the Owner’s and laid out all electric and installed all ceiling drops with wiring rough. Exterior metal clad windows and doors delivered. Crew installing insulation, roof decking
Day 35
October 12th, Tuesday

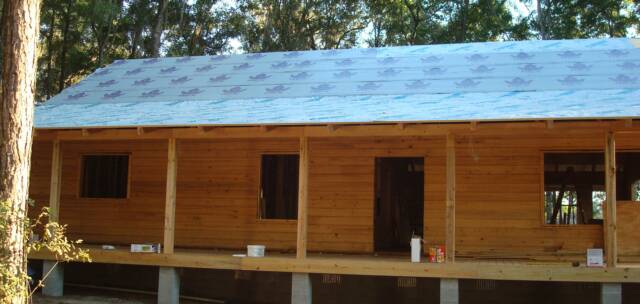

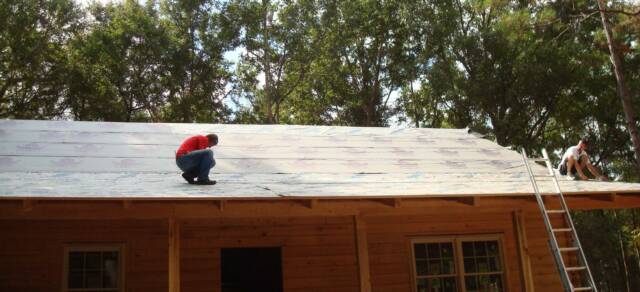

Day 35 – Crew installing insulation, roof decking and working on porches. Building Dept. on site today and signed off on sheathing inspection.
Day 36
October 13th, Wednesday
Day 36 – Crew working on porches.
Day 37
October 14th, Thursday
Day 37 – Crew working on porches and installing roof underlayment
Day 38
October 15th, Friday
Day 38 – Crew working on interior wall framing. Plumbers onsite working on rough in.
Day 39-40
October 16th, Saturday
Day 39 – Crew working on interior wall framing. Plumbers onsite working on rough in.
Day 40 – October 17th, 2010 Sunday – No Work
Day 41
October 18th, Monday
Day 41 – Crew working on window and door bucking and front covered porch system. Plumber onsite working on rough in.
Day 42
October 19th, Tuesday
Day 42 – Crew working on window bucking and bay window. Plumbers onsite working on rough-in. Electricians onsite working on rough-in. Hardwood and tile subcontractor onsite measuring layout for finish floors and shower hops.
Day 43
October 20st, Wednesday

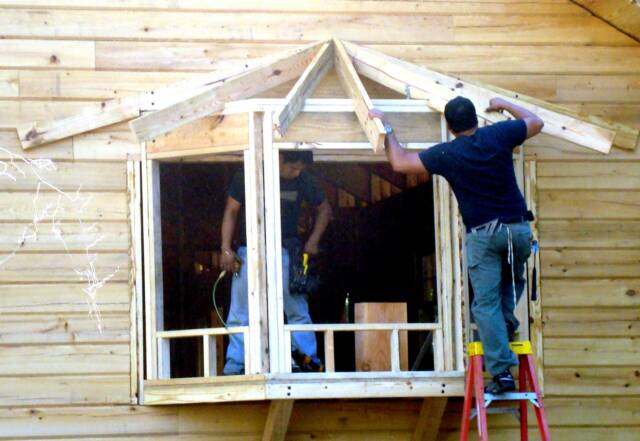

Day 43 – Crew installing windows. Framing bay window. Plumbers onsite working on rough-in and installing waterline to well.
Day 44-46
October 21th, Thursday
Day 44 – Crew framing 6/0 x 6/10 doors. Completing log to roof transition. Framing bay window.
October 22nd, Friday

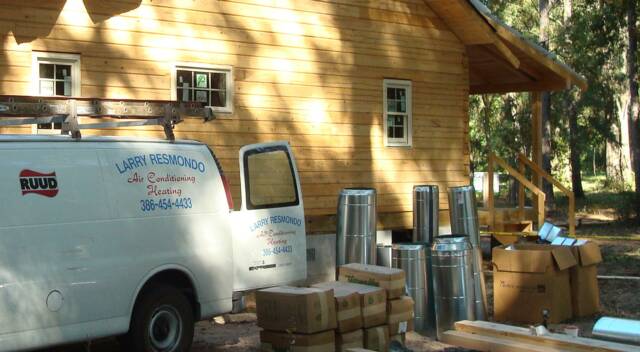

Day 45 – Crew working on misc. items, HVAC crew onsite, met with the owner and laid out all vents/returns and installed ductwork.
October 23rd, Saturday
Day 46 – Crew working on misc. items
Day 47-48
October 24th, Sunday
Day 47 – No Work
October 25th, Monday
Day 48 – Crew working on misc. items, drop ceilings, elect. cutouts, finished sheathing bay window and set both 6/0 x 6/10 exterior doors. H.V.A.C crew onsite, met with owner and laid out last 2 vents that were in conflict with floor structural members. “H.V.A.C rough-in complete.” Plumbers onsite, set tub and finishing rough-in. Metal roof contractor onsite taking finish roof measurements and ordered metal to be delivered tomorrow. Coordinated and completed all roof penetrations with roofing contractor (H.V.A.C, Plumbing, and Gas) Metal roof installation scheduled to start Wednesday.
Day 49
October 26th, Tuesday
Day 49 – Crew working on misc. items and framing fireplace. ” Plumbers onsite, finishing rough-in. Metal roofing delivered. Meeting onsite with owners to discuss porch rails and picket design.
